Auto scheduling issue

I have

this._gantt.config.auto_scheduling = {
  enabled:true,
  move_projects: false,
  use_progress:true,
  apply_constraints: true,
  gap_behavior: "compress" };
this._gantt.config.auto_scheduling_strict = false;
this._gantt.config.auto_scheduling_compatibility = false;
console.log(this._gantt.autoSchedule);
this._gantt.autoSchedule();

When I load the tasks my start date is automatically changing even if my progress is > 0. I have following code for checking progress to disable change of start_date but it is not working.

(this._gantt as any).attachEvent("onBeforeTaskAutoSchedule", (task: any, predecessor:any, link:any) => {
    // If the task has started, don't let the auto-scheduler move it
    if (task && task.progress > 0) {
        return false;
    }
    return true;
});

(this._gantt as any).attachEvent("onTaskUpdate", (id: any, task: any) => {
    if (task.progress > 0 && task.progress < 1) {
        task.constraint_type = "mso"; // Must Start On
        task.constraint_date = new Date(task.start_date);;
    }
});

Please help.

With Best Regards,
Dewang Bhansali

Hello Dewang,
You are trying to use both the configuration object and deprecated properties. This is not expected to work correctly. With that approach, the configuration object may be ignored:


So, you need to either use the deprecated configuration only or fully switch to the configuration object.

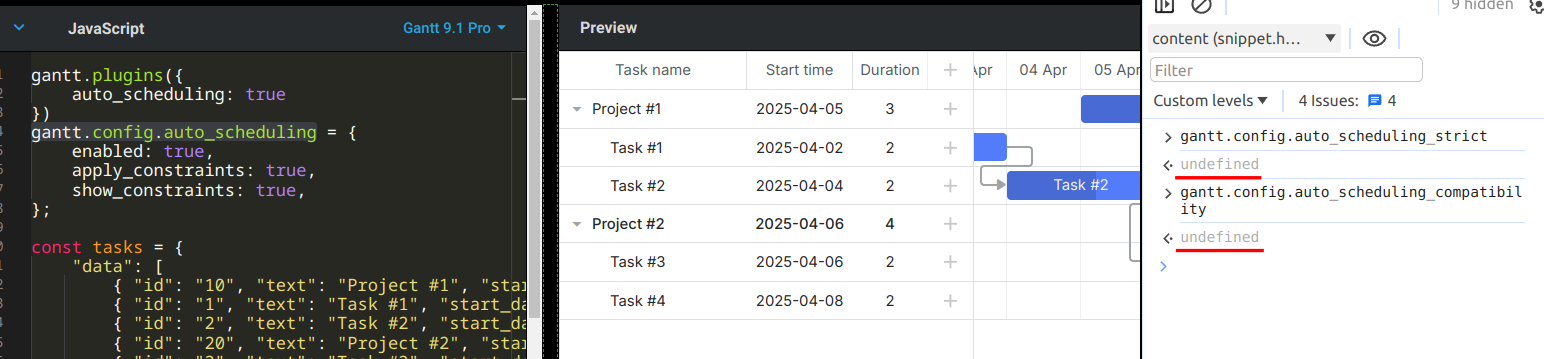

When I add the onBeforeTaskAutoSchedule event handler from the code you shared, it works correctly:
https://snippet.dhtmlx.com/l1p2pfj9

If you add the onBeforeTaskAutoSchedule event handler after the parse or load method, it is expected that it won’t work until the data is loaded. So, you need to add it before loading tasks.

Also, Gantt doesn’t have the onTaskUpdate event handler, but there are onBeforeTaskUpdate or onAfterTaskUpdate event handlers:

If you change set the constraint while changing the task progress, you will get an error because you would do that at the moment Gantt tries to auto-schedule the task (because the progress is changed):
https://snippet.dhtmlx.com/jdjbzwpc

So, in your case, it is better to use the onAfterTaskDrag and onLightboxSave event handlers to modify the task constraint:

Here is an example in the snippet:
https://snippet.dhtmlx.com/gwcl9ptt

Hello Ramil,

Thanks for your reply.

Even after changing the code taking initialization before the load of data it is still not executing OnBeforeTaskAutoSchedule. I am using angular for the same and have current 9.1 version of DHTMLX Gantt chart individual licence. Below is the code after changes

this.initializeGantt();

this.fetchdata('588','589')

}

initializeGantt() {

this._gantt.config.date_format = "%Y-%m-%d";

this._gantt.plugins({
  critical_path: true,
  auto_scheduling: true,
  // tooltip: true
});

this._gantt.config['open_tree_init'] = true;

const holidaylist = ['2025-01-26','2025-03-14','2025-05-01','2025-08-15','2025-08-27','2025-09-02',
                     '2025-09-06','2025-10-02','2025-10-18','2025-10-20','2025-10-21','2025-10-22',
                    //  '2026-01-26','2026-03-03','2026-05-01','2026-08-15','2026-09-14','2026-09-19',
                    //  '2026-09-25','2026-10-02','2026-10-20','2026-11-06','2026-11-08','2026-11-09','2026-11-10'
                    ]
holidaylist.forEach((holidayDate) => {
  const dateParts = holidayDate.split("-");
  const formattedDate = new Date(Number(dateParts[0]), Number(dateParts[1]) - 1, Number(dateParts[2]));

  // Mark the date as a non-working day
  this._gantt.setWorkTime({
      date: formattedDate,
      hours: false // false means non-working
  });
});

this._gantt.setWorkTime({ day: 6, hours: true }); // Saturday (Working)
this._gantt.setWorkTime({ day: 0, hours: false }); // Sunday (Non-working)
this._gantt.config.work_time = true; // Enable work time calculation
//this._gantt.config.highlight_critical_path = true;

this.SetTaskColor()


this._gantt.config.scales = [
  {
    unit: "quarter",
    step: 1,
    format: function (date) { // Middle scale: Quarter (e.g., Q1 2025)
      const quarter = Math.floor(date.getMonth() / 3) + 1;
      const year = date.getFullYear();
      return `Q${quarter} ${year}`;
    }
  },
  { unit: "month", step: 1, format: "%M" } // Bottom scale: Month (3 chars)
];
this.columnsToDisplay()

this._gantt.config.duration_unit = "day";

this._gantt.config.lightbox.sections = [
  {name: "description", height: 38, map_to: "text", type: "textarea", focus: true},
  {name: "time", type: "duration", map_to: "auto"},
  {name: "resolution", height: 38, type: "textarea", map_to: "resolutiondays"}
];

/*this._gantt.templates.tooltip_text = function (start, end, task) {
    const schstartdate = task["schstartdate"]
    const schenddate = task["finish_date"]
    const planstartdate = task["start_date"]
    const planenddate = task["planfinishdate"]
    const closeDate =
      !task["actualfinishdate"] ||
      task["actualfinishdate"] === "1900-01-01" ||
      task["actualfinishdate"].startsWith("1900-01-01")
        ? "-"
        : task["actualfinishdate"];

  return `
    <b>Task:</b> ${task.text}<br/>
    <b>Schedule Start Date:</b> ${schstartdate}<br/>
    <b>Schedule End Date:</b> ${schenddate}<br/>
    <b>Plan Start Date:</b> ${planstartdate}<br/>
    <b>Plan End Date:</b> ${planenddate}<br/>
    <b>Close Date:</b> ${closeDate}<br/>
    <b>Duration:</b> ${task.duration}<br/>

  `;
};*/

this._gantt.templates.task_end_date = (date) => {
    // 1. Subtract the day for inclusive display
    const inclusiveDate = this._gantt.date.add(date, -1, "day");

    // 2. Create a formatting function based on your config
    const formatFunc = this._gantt.date.date_to_str("%d %M` %Y"); //this._gantt.config.date_format);

    // 3. Return the formatted string
    return formatFunc(inclusiveDate);
};

this._gantt.config.auto_scheduling = {
  enabled:true,
  move_projects: false,
  use_progress: true,
  apply_constraints: true,
  show_constraints: true,
  gap_behavior: "compress",
  schedule_on_parse: false
};

this._gantt.autoSchedule();

(this._gantt as any).attachEvent("onBeforeTaskAutoSchedule", (task: any, predecessor:any, link:any) => {
    // If the task has started, don't let the auto-scheduler move it
    console.log("Before",task.text, task.progress);
    if (task && task.progress > 0) {
        console.log("Inside",task.text, task.progress);
        return false;
    }
    return true;
});


this._gantt.init(this.ganttContainer.nativeElement);

}

fetchdata(projectmkey: string,buildingmkey: string) {
this.isLoading = true;

this.ganttchartService.getTasks(projectmkey,buildingmkey).subscribe({
  next: (data: any) => {
    console.log(data);
    this.fullGanttData = data;
    this._gantt.parse(data);

    // --- Add this block to ensure all tasks are open ---
    this._gantt.eachTask((task) => {
      if (this._gantt.hasChild(task.id)) {
        this._gantt.open(task.id);
      }
    });
    // --------------------------------------------------

    // Highlight critical path
    // this._gantt.calculateCriticalPath();
    this._gantt.render();
    this.applyFilter();
  },
  error: (err) => {
    console.error(err);
    this.isLoading = false;
  },
  complete: () => {
    this.isLoading = false;
  }
});

}

Please help.

With Best Regards,
Dewang Bhansali

Hello Dewang,
In your configuration, the schedule_on_parse config is disabled. This means Gantt won’t auto-schedule tasks after loading them. They will be auto-scheduled if you do something that triggers auto-scheduling. For example, if you update a task or create a link.
If the tasks are not auto-scheduled, the onBeforeTaskAutoSchedule event is not expected to fire. You can change the schedule_on_parse config to true, then Gantt will auto-schedule tasks after loading them.

Also, though it is not related to the auto-scheduling, you are calling the open method for multiple tasks. When you do that, it is better to wrap the code with the batchUpdate method to repaint the changes only once:

This will improve performance. After that, you don’t need to call the render method as it will be called after the batchUpdate method.
